Keywords
delay factors, project management, risk management, construction industry, schedule delays
delay factors, project management, risk management, construction industry, schedule delays
The Central Aceh Regency is one of the regions in Aceh Province, Indonesia, experiencing rapid growth. This can be observed in the number of construction projects currently underway.1 The implementation of construction projects in the Central Aceh Regency often experiences failures and delays,1 which can cause project losses. Construction projects are dynamic and consist of limited resources. A complex project can cause high-risk and uncertain events that can cause delays and cost overruns on projects,2 thus allowing for uncertainty in the implementation process, which leads to various types of risks that ultimately cause losses to the parties involved in the construction project and affect the achievement of the desired goal. Risk is a condition in which there is a possibility of gain/loss,3 with losses, such as cost losses, injuries, and delays caused by uncertainty during project implementation. One of the most influential risk factors is changing the order.4 Delays in the implementation of projects are among the risks that often occur in the implementation of construction projects, especially in developing countries.5–8 Project delays and cost overruns can harm projects.9
An increase in fuel prices can cause cost increases, losses, and delays in construction projects.6,10 There are five causes for a project loss: (1) improper planning and scheduling, (2) many changes to orders by clients, (3) incompetent site management and supervision, (4) inexperienced subcontractors, and (5) poor contractor finances.11 Experienced contractors can accelerate a project schedule.12 The most influential risk factor for projects in Jordan (the Middle East) is poor soil/site conditions in construction projects.13
Previous research has shown that delays in project implementation can lead to cost overruns.14 Delays affect planning and control,15 especially during project implementation.16 Project delays can lead to losses, legal problems, and contract termination.17,18 The contractor suffers losses owing to cost overruns. For example, in Nigeria, cost overruns and delays are frequent factors affecting projects.19 It is important to apply risk management to avoid project failure because construction projects are complex and involve many risks.20 Project risk is defined as an unforeseen event or situation that can harm a project.21 Risk management is an important process for achieving project objectives.22,23 Identifying, assessing, and managing construction project risks is indispensable for risk management. A successful project is time- and cost-effective, and has good construction quality.24 Managing risk is an important mechanism in the construction sector, which is performed to obtain project objectives in the form of cost, time, safety, and good quality25; the most influential risk factor is material.26
Development projects globally often involve considerable risk. Inflation causes delays and losses.27 Risks can affect the time, cost, quality, and performance of a construction project.28 Time risk affects project costs. Project risk management aims to increase profits and reduce losses.29
For construction projects, overtime or delays are common during project implementation. Time delays can be described as events or interruptions that result in a project not being completed within the time specified in the contract. Defining delays as actions or activities that increase the time required by the contractor to conduct the project is referred to as time contingency.30
Only 30% of Saudi Arabian construction projects implemented require an average additional time of approximately 10–30%, where there are nine main groups of risk factors causing delays: costs, resources, contracts, schedule, government relations, personnel, planning, equipment, and environmental factors. Funding delay is the most important delay factor.31 In project implementation, the contractor company does not know the risk of project delays. Therefore, to avoid losses and delays in construction projects, research is needed to identify and analyze the factors causing delays in construction projects, particularly in Indonesia and the Central Aceh District, given the complex conditions of the district, including socio-cultural diversity, high inflation rates, low public education, frequent disasters, community economy weakness, geographic location, social and political conflicts, and economic crises.32
Risk identification is conducted by collecting all information related to activities and analyzing it to find every possible risk that could result in a loss. Risk identification can be performed using several techniques.33 Identifying risks in a project consists in compiling (1) a list of risks that can cause losses, (2) a list of potential losses, and in this checklist compiling (3) a list of losses and (4) a ranking of losses occurring, and then (5) classifying losses. Project delays also occur owing to work accidents.34 The type of soil and rock at the project site is one of the main risk factors for project delay.35
The primary data in this study was questionnaire data; the questionnaire was distributed to 47 respondents and contained 80 questions about project delays. Secondary data were obtained from studies in the literature such as journals, books, and other literature related to this research, as well as data about contractor companies obtained from the National Construction Services Association. The distribution of questionnaires aimed to determine the level of influence of risk factors causing project delays; a closed questionnaire was used, where answer choices had been determined in advance, and respondents were given the opportunity to choose the most appropriate answer.36 For data processing, we used a validity test, a reliability test, and descriptive analysis.
The questionnaire was composed of two parts: questionnaire A and questionnaire B. Questionnaire A concerned the characteristics of respondents, and questionnaire B concerned the level of influence of factors causing project delays. Assessment of the level of influence of 80 project delay risk factors was carried out using a Likert scale, which consists of five points as defined in previous studies (e.g., References 31,37,38). The Likert scale has previously been used to measure the perceptions of respondents about social events39–41 and can be seen in Table 1.
The data collected for this research were questionnaire data, from questionnaire tools distributed to respondents, namely contractor companies located in Central Aceh District. The collection of data was carried out over two months by the researchers. This study used probability sampling, namely simple random sampling in distributing questionnaires. Simple random sampling technique is a technique consisting in taking samples randomly from members of the population.42 The targeted respondents were contractors from the Central Aceh Regency, which has a population of 53 contractor companies. The experimental procedures were approved by the Institutional Review Board at Syiah Kuala University (IRB protocol number 99). All of these experimental methods were carried out in accordance with the regulations of the Institutional Review Board of Syiah Kuala University in Indonesia, and all participants gave their informed consent. The total sample size was 47 companies, calculated from the total population with an inaccuracy allowance of 5%, then by using the Slovin formula.43 Data collection was performed by distributing questionnaires to respondents directly.
Table 2 shows that based on the identification of risk factors for delay, there were 80 causes of construction project delays, which were categorised into seven main factors.
Descriptive statistics are used to collect, organize and process data to be presented and provide a clear picture, regarding a particular condition or event where the data is taken. Descriptive statistics are to present data clearly, in order to be taken or certain meanings.44 Descriptive statistics provide an overview of the object under study through sample or population data without analyzing and making conclusions that apply to the public.45 Quantitative descriptive research describes data in the form of numbers, and the size of the data includes the mean value, mode, and median. The size of the data deployment includes variance and standard deviation.46 Descriptive statistical analysis determines the most influential factors on project delays, and uses mode value, which is the data that appears most often.
The validity test is a tool to test whether each question item truly reveals the factors or indicators that need to be investigated.47 Validity testing was performed by distributing the questionnaires to 20 respondents. A validity test was performed for each variable using Pearson's product moment analysis. The variable was considered valid if the rxy value was greater than the r-table value. The r-table value obtained was 0.288, with degrees of freedom (df) associated with or an error level of 0.05, in both directions. The question had a value greater than 0.288; therefore, the questionnaire was deemed feasible and valid.
A reliability test was conducted to determine whether the questionnaire was reliable, with a coefficient of ≥ 0.6. If the value was above 0.60, the questionnaire was considered reliable and feasible to use.48
As shown in Table 3, a reliability coefficient of 0.958 was obtained. This shows that the coefficient of Cronbach's alpha for the variable causing the delay was greater than 0.6. Therefore, the questionnaire was deemed to be reliable.
Questionnaires were distributed to 47 respondents; their characteristics are presented in Table 4.
Questionnaires were distributed to 47 respondents, and the results of distributing questionnaires on the characteristics of the respondents can be concluded based on the results of the research in Table 4. It was found that most companies, that is, 18 companies (38.30%) had over 15 years of experience in the construction sector, and the majority (26 companies, 55.32%) had handled several construction projects above 10. The majority, i.e.41 companies (87.23%) had estimated project durations of 0–6 months per year.
A descriptive analysis was used to determine the level of influence of the delay risk variable. The descriptive analysis uses the mode value to determine the data that appear most often, and thus the responses that are most chosen by the respondents are obtained. The results of the levels of the factors influencing project delays are shown in Table 5.
Table 6 shows that of the 80 variables causing project delays, based on the respondents' opinions, there were eight risk factors in the very high influence category (Mode = 5), 71 factors of high influence category (Mode = 4), and one factor that belonged to the medium influence category (Mode = 3).
Level influence | Number of items |
---|---|
Very high influence | 8 |
High influence | 71 |
Medium influence | 1 |
Low influence | 0 |
Very low influence | 0 |

Figure 1 shows that the research results identified eight factors causing project delays that had a mode value of 5, including the very high influence category: tool malfunction, cost estimation inaccuracy, increased work costs, implementation of new technologies, details, inappropriate accuracy and conformity to specifications, workers quarrel, poor project planning and control, poor condition at locations, and accessibility difficulty.
Figure 1 shows that of the 47 respondents, 21 (44.68%) chose the very high influence category (mode =5) for the tool malfunction factor. Cost estimation inaccuracy was chosen by 20 respondents (42.55%), increased work costs by 22 respondents (46.81%), implementation of new technologies by 25 respondents (53.19%), details, accuracy, and conformity to specifications that were not appropriate by 20 respondents (42.55%), workers quarrel by 20 respondents (42.55%), poor project planning and control by 22 respondents (46.81%), poor condition at locations, and accessibility difficulty by 20 respondents (42.55%).

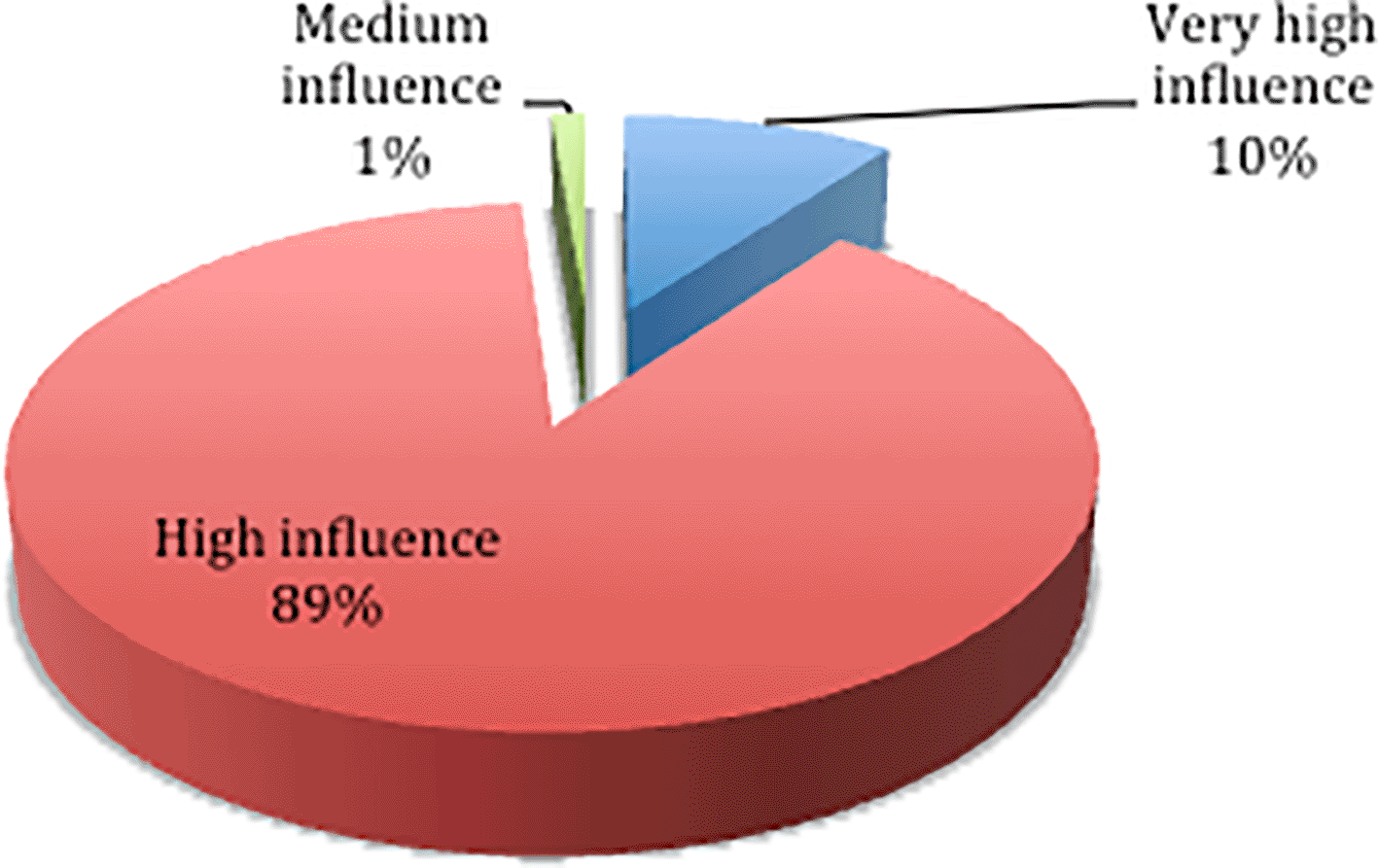

Based on the results of the questionnaire distribution, Figure 2 shows that 89% of respondents chose the high influence category, 10% chose the very high influence category, and 1% chose the medium influence category. The results of the descriptive statistics on the influence level of each delay factor are shown in Table 5.
Factor 1: Tool malfunction
The distribution of ratings for the mode value for tool malfunction was 5 (very high influence). Therefore, the results of the study indicate that the majority of respondents rated the tool malfunction indicator as having a very high influence on project delays.6,49,50 Equipment damage can cause losses and endanger workers. One of the problems that often occurs is the tool’s age; the tool becomes damaged if it is too old. To avoid damage to the tool, it is best to perform routine and periodic maintenance such that the tool is more durable in operation.
Factor 2: Cost estimation inaccuracy
The mode value for the cost estimation inaccuracy was 5 (very high influence). Therefore, the results of the study show that the majority of respondents rated the cost estimation inaccuracy indicator as having a very high influence over project delays. Cost estimation inaccuracies can result in delays and losses.49 Cost estimation is a calculation of the costs required to complete an activity or work in accordance with the requirements or contract; therefore, if the cost calculation is not appropriate, risk increases and can cause losses to the project. Therefore, accurate cost estimation is required to avoid risk. The main risk and uncertainty factor in a project is the estimated cost.51
Factor 3: Increased work costs
The mode value for the increased work cost indicator was 5 (very high influence). Therefore, the results of the study indicate that the majority of respondents assess the indicator of increased work costs as having a very high influence on project delays. Cost overruns often occur in a project because the project implementation costs are greater than the project budget planning that has been set at the initial stage (estimated), which can cause significant losses for the project contractor. An increase in work costs is one of the causes of project delays.6,52 The increase in the cost of work needs to be considered because it involves the amount of investment that must be made by the owner, where the cost overrun is vulnerable to the risk of failure. Therefore, project costs must be managed properly to minimize the possibility of cost overruns. Cost control is the final step of the project cost management process, which ensures that the use and expenditure of costs are in accordance with the planning in the form of a predetermined budget, and thus there is no increase in work costs.
Factor 4: Implementation of new technologies
The mode value for the implementation of new technologies was 5 (very high influence). Therefore, the results of the study indicate that the majority of respondents assessed the implementation of new technologies as having a very high influence on project delays. The development of new technological innovation and creativity is key to winning over competition and building resilience in the construction industry.53 Mastery and utilization of technology is needed by construction industry players to compete globally.53 The application of new and special technology that is not well known is a risk factor for project implementation because if the contractor does not know or understand new technology, it can hinder the implementation of the project, cause the project to fail or not be in accordance with the plans and losses, and can cause project delays.6,49
Factor 5: Details, accuracy and conformity to specifications that are inappropriate
Inappropriate details, accuracy, and conformity to specifications have a mode value of 5 (very high influence). Therefore, the results of the study indicate that the majority of respondents assess the indicators of detail, accuracy, and conformity to specifications that are inappropriate as having a very high influence on project delays. However, inappropriate specifications can hinder the implementation of construction projects.49
Factor 6: Workers quarrel
The workers’ quarrel factor had a mode value of 5 (very high influence). Therefore, the results of this study indicate that the majority of respondents assessed the indicator of workers’ quarrels as having a very high influence on project delays. Workers’ quarrels are a risk factor that can disrupt the project because if there is a fight between workers, project implementation will automatically stop and cause delays.6,50 A method often used to resolve conflicts occurring between workers and in human resources on projects is a problem-solving approach, namely, discussing openly and directly using dialogue between the parties involved, identifying problems that cause conflict, seeking and collecting information on the causes of conflict, and analyzing various alternatives that are considered to be the best solution.54
Factor 7: Poor project planning and controlling
Poor project planning and controlling factors had a mode value of 5 (very high influence). Therefore, the results of this study indicate that the majority of respondents assessed poor project planning and control as having a very high influence on project delays. Poor project planning and control are weaknesses that can lead to the possibility of a project not going as planned, and the project results are also likely not to run as expected. Therefore, poor project planning and control can result in delays and losses for the contractors. Contracting companies have a significant influence on project delays.55,56 The views of clients and contractors on the causes of delays differ as they tend to blame each other for unfortunate incidents.14,50,57
Factor 8: Poor conditions at locations and accessibility difficulty
The majority of respondents rated poor conditions and accessibility difficulty at locations as having a very high influence on project delays, where the distribution of ratings for the mode value was 5 (very high influence). Construction locations can be in poor conditions and inaccessible in the Central Aceh District, which is hilly and surrounded by mountains, making access to project sites quite difficult. Poor and difficult-to-reach project site conditions can affect project delays and potentially cause project failures6,58 because of (1) a lack of initial information on field conditions, (2) contractors not conducting initial surveys, and (3) the work environment not being prepared, such as land clearing and acquisition, fresh air supply, and adequate lighting.59 To avoid project delays and failures, it is expected that the contractor can collect information and conduct an initial survey regarding the condition of the project site before implementing the project such that the contractor can plan strategies for the project to run smoothly.
The Indonesian government is actively engaged in construction in various sectors to create prosperity and welfare for its people. However, there are still many obstacles to working on construction projects that are not in accordance with the planned schedule. One of these obstacles is delays in construction projects. Obstacles and risks often occur during project implementation, resulting in project delays and losses. Delay in the implementation of construction projects is one of the risks that often occurs in the implementation of construction projects, especially in developing countries. Project delays for contractors can cause time and cost losses because the profits expected by the contractor are reduced, the contractor does not obtain the expected profits, or there may even be no profits at all. For project owners, delays in completing work can cause losses. Various methods have been implemented to avoid the problems that result in delays and losses. Identifying the root causes of delays is an important first step in mapping the problems that can cause project delays. The correct solution or strategy to overcome delays will be easier to obtain if the project has a map of the main factors that can cause the project to experience delays in the schedule. In this study, 80 factors causing project delays were identified, of which eight main factors were categorized as having a very high influence (=5) in causing project delays.
The findings of this study are useful for academics and construction practitioners with potentially deeper insights into the root causes of project schedule delays. The continuous expansion of knowledge and understanding of the importance (criticality) of the causes of delays will assist stakeholders in reducing the incidence of delays, lead to appropriate strategies, and can be used as comparisons or benchmarks in development planning; thus, by knowing the causes of these delays, the contractor can properly calculate these risks to avoid losses impacting the project. However, further research should be conducted with a wider study area to increase the number of respondents.
This study has limitations, namely, sampling was only conducted in the Central Aceh District, and the scope of the study is not wide enough; therefore, the results of the study cannot be generalized to a wider population. The results of this study are specific to Central Aceh Regency, and are not expandable to other regions in Indonesia. Thus, similar studies can be conducted in other districts, provinces, and cities in Indonesia, and the results of the research can be generalized to other regions. Further research is needed to increase the number of respondents such that the results are more comprehensive.
Our future research will aim to determine the effects of delay factors on construction project costs using the ordinal logistic regression method. Future research will be conducted to determine the delay factors that have a significant effect on construction project costs. These delay factors are expected to serve as a reference for contractor companies carrying out construction projects such that they can avoid construction project losses.
